The subsidy math your sales team quotes today, ₹30,000 per kW for the first 2 kW, ₹18,000 for the third kW, capped at ₹78,000, is what the MNRE guidelines (amended July 2025) say, and the scheme period runs to 31 March 2027. Press reports say that on July 24, 2026, the Ministry of New and Renewable Energy (MNRE) held a stakeholder consultation on the scheme's next phase. The name "PM Surya Ghar 2.0" comes from press coverage; we found no MNRE document that uses it. The reported idea is to redesign how the PM Surya Ghar Muft Bijli Yojana pays for rooftop solar, moving from a one-time capacity-linked subsidy to a structure that would reward actual electricity generation, fund battery storage, and reach more apartment residents.

Nothing here is notified policy. As of 31 Oct 2026 we found no MNRE press release, circular or policy paper on any of it. Everything below that is not marked as official comes from press reports (Times of India and Financial Express) that we could not check against an official document, so treat it as unconfirmed. The direction may still matter for anyone quoting PM Surya Ghar systems today, so it is worth understanding before it becomes a circular you have to react to overnight.

Rooftop solar panels installed on residential homes in Mehsana, Gujarat, India
Rooftop solar on residential homes in Mehsana, Gujarat. Photo: Nizil Shah, Wikimedia Commons, CC BY-SA 4.0.

Key takeaway

PM Surya Ghar 2.0 is a reported idea, not a live policy. Press reports say MNRE is considering a framework that would link part of the subsidy to actual electricity generation rather than installed capacity alone, add support for battery storage, extend the scheme to apartments through virtual and group net metering, and impose stricter maintenance and generation-guarantee obligations on vendors. The reports said a consolidated policy paper was expected within 10 to 15 days of the July 24, 2026 consultation; we have not found one as of 31 Oct 2026. The only official statement we found is a Minister's remark in a PIB release of 4 Jun 2026 that MNRE will integrate battery storage as costs decline and expand adoption through the Model Solar Village initiative.

What Has Actually Been Announced So Far

Nothing has been notified. According to press reports, what happened is a stakeholder consultation, not a scheme launch, and the distinction matters for anyone tempted to change their pitch this week. The one official data point is a PIB release of 4 Jun 2026, in which the Minister said: "looking ahead, we will integrate Battery Energy Storage Systems as storage costs decline and expand adoption through the Model Solar Village initiative."

Press reports say MNRE held a closed-door brainstorming session on July 24, 2026, bringing together ministry officials and industry stakeholders to review the first phase of PM Surya Ghar and identify what needs to change in the next one. According to Times of India's reporting on the meeting, officials acknowledged the scheme had succeeded in creating demand and establishing residential rooftop solar as a functioning national market, then turned to a list of unresolved problems: battery storage, grid integration, DISCOM readiness, consumer access, asset performance, financing, quality assurance, and long-term market sustainability.

A senior MNRE official told Financial Express that "the next phase should not be limited to continuation of the existing subsidy structure," framing the redesign as a mix of regulation, market mechanisms, technology standards, and public support meant to deepen adoption while gradually building a self-sustaining market rather than a permanently subsidised one.

The most concrete detail to emerge is the timeline for the paperwork itself: a consolidated policy paper is expected within 10 to 15 days of the meeting, followed by roughly 20 days of focused consultations on batteries, hybrid inverters, equipment interoperability, DISCOM readiness, and regulatory changes. That would have put a full draft framework somewhere around mid-September 2026, but we found no such draft as of 31 Oct 2026, and Financial Express reported that MNRE did not respond to its queries before publication.

Why the Government Wants to Redesign a Scheme That's Working

PM Surya Ghar is not failing. That is precisely why this redesign is happening now rather than as crisis management.

Launched on February 13, 2024, with a financial outlay of ₹75,021 crore, the scheme has a headline target of one crore rooftop solar households by March 2027. As of 22 Jul 2026, PIB reported about 39.7 lakh installations covering about 48 lakh households (Rajya Sabha reply, 28 Jul 2026), and 51.58 lakh households benefiting as of 12 Aug 2026 (PIB, 13 Aug 2026). That is real momentum, and it is also exactly the scale at which the scheme's original design assumptions start to strain.

The current structure pays a fixed subsidy per kilowatt of installed capacity, up to ₹78,000, regardless of how much electricity the system actually generates over its lifetime, how well it is maintained, or whether the household can even use a rooftop in the first place. The press reports describe three structural gaps:

Vendors disappear, and warranties disappear with them. MNRE officials flagged that a meaningful share of homeowners can no longer get repairs or warranty service because the vendor that installed their system has shut down or exited the market. A subsidy paid entirely at commissioning gives installers no financial stake in a system's performance five years later.

Battery storage gets no subsidy of its own. The current guidelines allow a battery in the installation, but the CFA is calculated on solar module capacity only (clause 5(l)), and grid-connected battery hybrids are eligible subject to State Commission approval (clause 6(o)). An official was reported by Times of India as saying batteries were kept out of the subsidy because they would have raised costs and created an access barrier for first-time adopters. The press reports link the question to rising daytime exports that DISCOMs have to manage.

Many households have a limited route in. The current guidelines do cover housing societies and RWAs for common facilities (₹18,000/kW, up to 500 kW at 3 kW per house, on a dedicated connection) and group or virtual net metering installations on a roof, if the DISCOM approves the arrangement (clauses 5(b), 5(e), 5(f)). Even so, a flat owner who has no roof access of their own has no direct individual route. That is the gap the press reports say the redesign would address.

Our read. If the reports are accurate, this is not a scheme in trouble looking for a rescue. It is a scheme that grew fast enough to expose the next layer of questions: what happens to a system in year six, and who has no route in. That is our reading of the reports, not an official position.

Timeline: What Happens Next, and When

  1. 1

    July 24, 2026, Stakeholder consultation held

    A senior MNRE official is reported to have chaired a brainstorming session with ministry officials and industry stakeholders on the shape of PM Surya Ghar's next phase.

  2. 2

    Early-to-mid August 2026, Consolidated policy paper

    Financial Express reported that a policy paper was expected within 10 to 15 days of the consultation. We found no such paper as of 31 Oct 2026. It would be the first document that shows whether the proposals below survive drafting intact.

  3. 3

    Mid-August to mid-September 2026, Focused consultations

    The reports said roughly 20 days of technical consultations on batteries, hybrid inverters, equipment interoperability, DISCOM readiness, and regulatory changes would follow the policy paper. We have not found any record of these.

  4. 4

    Date not confirmed, Cabinet approval and notification

    Neither source article gives a notification date. A scheme of this scale would still need Cabinet Committee on Economic Affairs sign-off before it becomes operational, expect this to land well into 2027 given the current phase runs through March 2027.

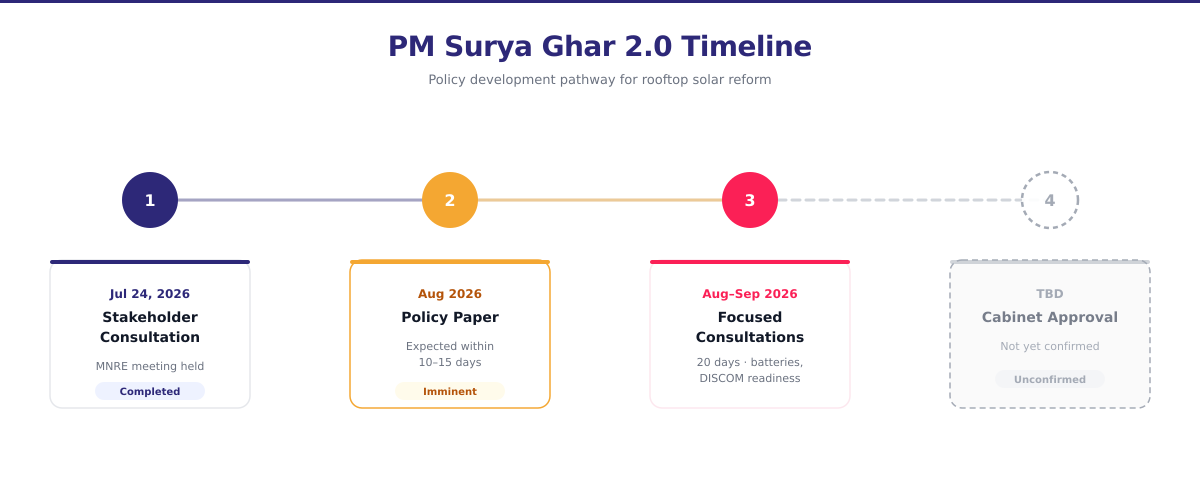

PM Surya Ghar 2.0 policy timeline showing stakeholder consultation, policy paper, focused consultations, and pending cabinet approval

Fast tip. Do not change your live proposal templates based on this article. Every number in it is a proposal under discussion, not a notified rate. Track our PM Surya Ghar policy updates tracker for the moment any of this becomes an actual MNRE circular.

The Proposed Policy Changes, In Detail

Six ideas came out of the July 24 consultation and the ministry's internal thinking, according to the two press reports. None are finalised, and none are confirmed by an MNRE document we could find.

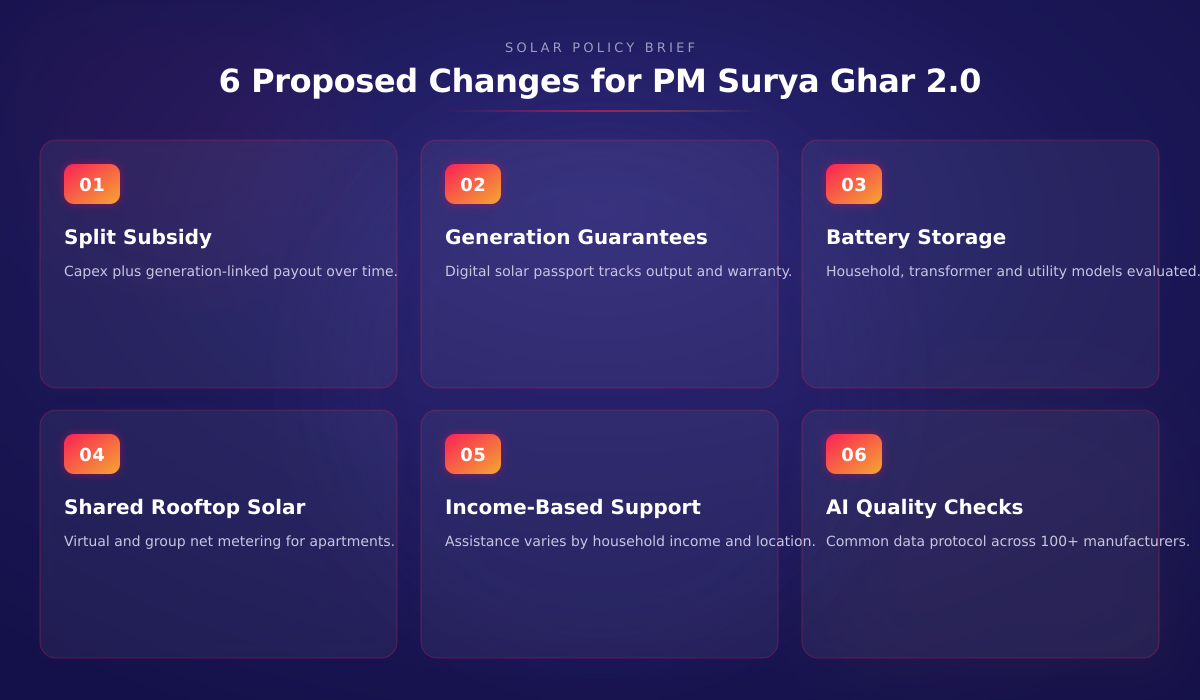

Dark-mode infographic listing the six proposed changes for PM Surya Ghar 2.0: split subsidy, generation guarantees, battery storage, shared rooftop solar, income-based support, and AI quality checks

1. A split financial-assistance structure. Rather than one lump-sum subsidy at commissioning, the proposed model separates support into two components: one covering upfront capital expenditure, the other linked to electricity generation, operations and maintenance, battery storage, or service delivery spread over the asset's operating life. In effect, part of the subsidy would be paid out over time, conditional on the system actually producing power.

2. Generation guarantees and a digital solar passport. The MNRE official quoted by Financial Express said the programme "should shift from an installation-centric model towards an asset-performance model." Concrete proposals include generation guarantees, mandatory service periods, insurance against equipment failure and generation shortfall, and a digital solar passport that records a system's output, service history, and warranty status over its lifetime.

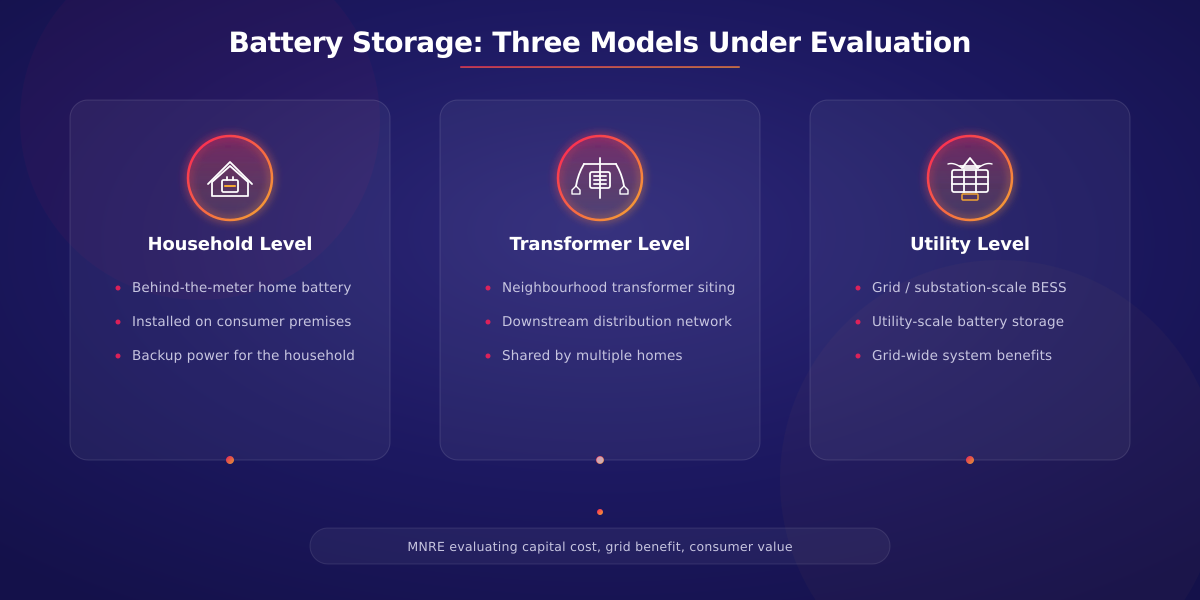

3. Battery storage evaluated at three different levels. MNRE plans to compare household-level, neighbourhood-transformer-level, and utility-scale battery storage models on capital cost, grid benefit, avoided infrastructure spend, consumer value, and operational control before settling on a preferred approach. Two storage pathways were specifically discussed: behind-the-meter batteries at the consumer's premises, and battery systems deployed downstream in the distribution network. A benefit-sharing mechanism is also under consideration, where a share of the savings DISCOMs realise from power-purchase optimisation and avoided network expenditure could be passed back to consumers who install batteries.

Dark-mode infographic comparing three battery storage models under evaluation: household level, transformer level, and utility level

4. Shared and virtual rooftop solar for apartments. The scheme may expand to cover apartment residents and households without a suitable rooftop through virtual net metering, group net metering, balcony solar, facade-mounted systems, and building-integrated photovoltaics. Community solar plants of roughly 100 kW are also being explored specifically for low-income consumers who want systems in the 1 to 2 kW range but have nowhere to put one.

5. Income and location-differentiated support. Officials reportedly expect adoption to remain strong as long as payback stays in the five-to-six-year range, but weaken once payback stretches past seven years. The proposed response is to differentiate financial assistance by household income, location, consumer category, and the value a given system provides to the grid, higher-income households would need less support, lower-income households more, or a differently structured one.

6. AI-based quality checks and a common data protocol. MNRE is reportedly planning a common data protocol spanning more than 100 inverter and equipment manufacturers, with daily generation data feeding DISCOM planning, maintenance alerts, and warranty enforcement. AI would be used to verify installations, identify components, and detect defects, addressing the quality-assurance gap that has let underperforming systems slip through empanelment.

48 Lhouseholds

Benefiting from Phase 1 so far

Source: PIB, 28 Jul 2026 (as on 22 Jul 2026)

₹75,021 Croutlay

Phase 1 financial outlay

Source: MNRE guidelines, clause 1(b)

31 Mar 2027ends

Current scheme period

Source: MNRE guidelines, clause 2(d)

100 kWplants

Reported community solar size (unconfirmed)

Source: Financial Express, Jul 2026

PM Surya Ghar Today vs. the Proposed 2.0 Framework

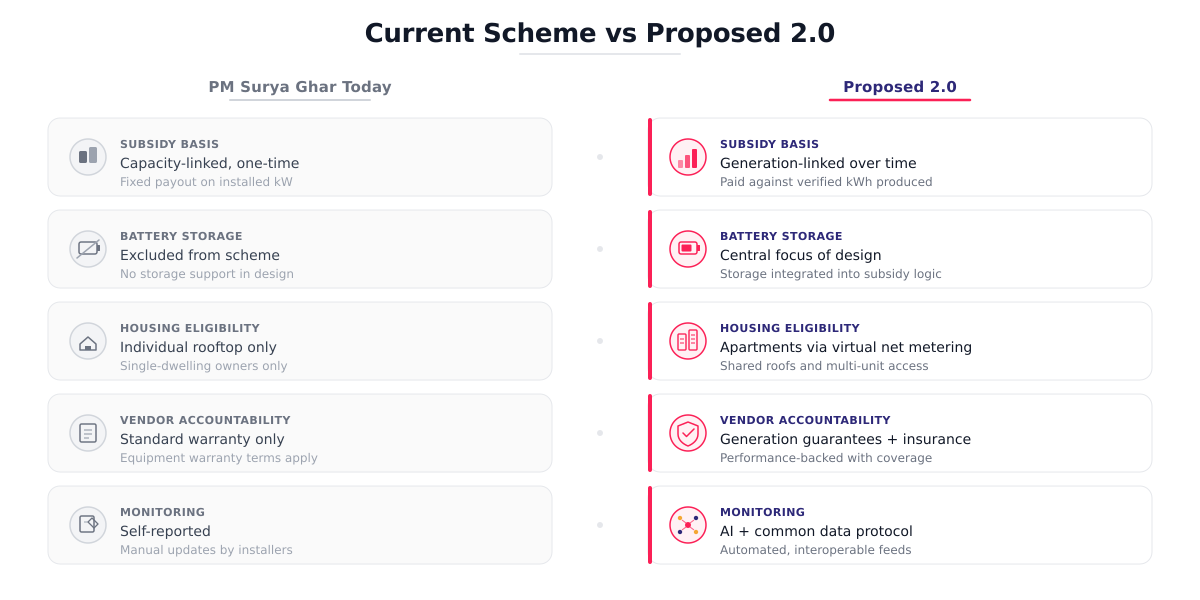

Infographic comparing PM Surya Ghar today with the proposed 2.0 framework across subsidy basis, battery storage, housing eligibility, vendor accountability, and monitoring
Dimension Current scheme (2024-2027) Proposed 2.0 framework
Subsidy basisInstalled capacity, paid once at commissioningSplit, capex plus generation/O&M/storage linked over asset life
Battery storageAllowed in the installation; CFA is on module capacity only, no subsidy for the battery (clauses 5(l), 6(o))Central to the redesign, household, transformer and utility-level models under evaluation
Eligible housingIndividual rooftops; societies and RWAs for common facilities up to 500 kW; group or virtual net metering on a roof if the DISCOM approves (clauses 5(b), 5(e))Apartments and no-rooftop households via virtual/group net metering, balcony and facade solar
Vendor accountabilityVendors owe 5 years of free repair and maintenance (clause 7(d)); de-registration possible after notice (clause 7(e))Generation guarantees, mandatory service periods, equipment-failure insurance
Support differentiationUniform slab regardless of incomeSupport varies by income, location, consumer category, grid value
MonitoringGeo-tagged photos and DISCOM physical inspection; generation data tracking on the portal is envisaged (clause 8(a)(ix))Common data protocol across 100+ manufacturers, AI-based installation verification

For the exact rupee figures the current scheme still uses while this redesign is under discussion, see our breakdown of the current PM Surya Ghar subsidy slabs, and how the subsidy compares with other CFA-type programmes.

Industry Reactions

The public reaction we found is limited and comes from one press report, which is broadly welcoming of the direction while stressing execution.

Ashish K Sharma, fellow at TERI, told Financial Express that "India's rooftop solar story is entering a new phase. The question is no longer how many panels we install, but how effectively we use the energy they generate. Storage is the missing link that can align consumer savings with grid requirements and make distributed solar more valuable for the entire electricity system." That framing, effectiveness over volume, is likely to define how the industry evaluates every proposal that comes out of this consultation.

We have not surveyed installers, so this is our own reading rather than market data. High-volume EPCs may be wary of anything that pushes part of the subsidy payout later, since it would strain working capital. EPCs already building O&M and service revenue may see performance-linked support as a good fit.

Expected Challenges

What could work

  • ✓Generation guarantees push vendors toward better quality equipment and honest sizing
  • ✓Virtual/group net metering unlocks a large apartment-dwelling market currently shut out
  • ✓Battery benefit-sharing gives DISCOMs a reason to actively support adoption, not just tolerate it
  • ✓A common data protocol makes warranty enforcement provable instead of he-said-she-said

What could go wrong

  • ✗Generation-linked payouts require metering and data infrastructure most DISCOMs don't have today
  • ✗Deferred subsidy components strain EPC cash flow, especially for smaller installers
  • ✗Virtual net metering needs state-level regulatory changes, DISCOM readiness varies enormously by state
  • ✗Mandatory service periods and insurance push up system cost right as the government wants to keep it affordable

The DISCOM-readiness problem is the one worth sitting with the longest. Virtual and group net metering already exist on paper in several state regulations, but implementation quality varies as widely as the DISCOM approval timelines we track do today. A national policy that assumes uniform DISCOM capability to execute generation-linked payouts and virtual metering will run into the same state-by-state friction that PM Surya Ghar Phase 1 has dealt with since 2024,.

Benefits of the Proposed Redesign

If the framework survives roughly as described, the benefits cluster around three groups. Consumers get systems that are more likely to keep working, and more likely to be backed by someone accountable, since insurance and service-period mandates attach real consequences to vendor abandonment. DISCOMs get a grid-management tool, battery storage deployed with their input rather than around them, plus better visibility into distributed generation through the common data protocol. And the addressable market expands meaningfully, apartment dwellers and households without usable rooftops make up a large share of urban India's electricity consumers, and many of them have no direct route into PM Surya Ghar today.

For EPCs, the benefit is less obvious but potentially larger: a subsidy structure that rewards ongoing service delivery is a subsidy structure that finally puts a price on the O&M relationship most installers already want to build but struggle to monetise against a market trained to think of solar as a one-time purchase.

Expert Analysis: What This Signals About India's Solar Policy Direction

Reading the two source reports together, the through-line is a shift from subsidising installation to subsidising outcomes. That is a harder policy to design and a harder policy to game, which is likely the point. A capacity-linked subsidy can be captured by installing cheap, underperforming equipment that still qualifies for the full payout. A generation-linked component cannot be captured the same way, because the money only flows if the system actually produces power.

The MNRE official's framing, regulation, market mechanisms, technology standards and public support working together rather than public support carrying the scheme alone, suggests a second phase that is more conditional than the first. PM Surya Ghar 2.0, on this reading, is that second phase arriving roughly on schedule, thirty months after launch, at just past the halfway point to the one-crore-household target.

The caveat worth stating plainly: policy papers in Indian energy governance frequently take longer to become notified schemes than the stated timeline suggests, and often emerge simplified from what stakeholder consultations first propose. The gap between "MNRE is evaluating three battery storage models" and an actual notified subsidy line item for household batteries could be twelve months or more, or it may never happen.

What This Means for Your Business Right Now

None of this changes what you quote today. The current slabs, ₹78,000 max on 3 kW, remain in force and will likely stay in force through the rest of Phase 1's run to March 2027, since large government schemes rarely switch mid-stream for consumers already in the pipeline. One live component worth reading meanwhile is the district-level Model Solar Village challenge.

What is worth doing now: if your business already leans toward O&M contracts, service plans, or battery-ready design, this redesign signals the market will reward that positioning more directly. If you've been purely install-and-move-on, start building the service-delivery muscle before it becomes a requirement rather than after.

How Quickest Solar CRM Fits

Whatever a next phase ends up looking like, if it happens, EPCs may need to track more per project than a single subsidy number, for example split capex and service components, battery sizing and service-period obligations. Most teams still do this in spreadsheets.

  • Proposal Generator, Proposal templates carry your logo, items, photos and terms, with the PM Surya Ghar subsidy applied in the proposal. If the subsidy structure changes, you update your template and terms yourself and check the figure against the official notification.
  • Pipeline Management, Use customisable lead stages, labels and follow-up reminders to track each customer's subsidy stage and any service follow-ups in one place instead of scattered folders.
  • Quotation System, If financial assistance ever splits into capex and performance-linked components, your quotes will need to show both clearly. Quickest's admin-set price list with margin and itemised proposals give you a starting point, and you would add any new subsidy components to the terms yourself.

For the design and engineering side of battery-ready proposals, SurgePV's guide to hybrid solar system design covers how to size a battery-ready system before MNRE settles on its preferred storage model.

What to Watch, For Your EPC This Quarter

  1. Do not change your live proposal templates. Every figure in this article describes a proposal under discussion. Keep quoting the current ₹78,000-capped slabs until MNRE issues an actual notification.

  2. Watch for an official MNRE document. The press reports expected a policy paper within 10 to 15 days of July 24, 2026, and we have not found one as of 31 Oct 2026. An official paper or circular, not this article or the source reports, will be the first real signal of what survives into a notified scheme. We will update our PM Surya Ghar policy tracker the moment it lands.

  3. Start building your O&M and battery-sizing capability now. Whatever the final subsidy mechanics look like, service delivery and storage expertise are clearly becoming more central to the scheme, and to the business, than they were in 2024.

Frequently Asked Questions

Is PM Surya Ghar 2.0 a confirmed government scheme?

No. As of 31 Oct 2026, "PM Surya Ghar 2.0" is a name from press reports about proposals discussed at an MNRE stakeholder consultation on July 24, 2026. We found no MNRE press release, circular or policy paper confirming any of it. No subsidy structure, launch timeline, or notification date has been confirmed by the ministry.

Will PM Surya Ghar 2.0 include a subsidy for home batteries?

Today, a grid-connected system with a battery can still get PM Surya Ghar CFA, but the CFA is calculated on solar module capacity only, so the battery itself is not subsidised (MNRE guidelines, clauses 5(l) and 6(o)). Press reports say battery storage is central to the proposed redesign, with household-level, transformer-level and utility-scale models being compared, but that is unconfirmed, and a Minister's PIB remark of 4 Jun 2026 only says batteries will be integrated as costs decline. No confirmed battery subsidy amount exists.

Can apartment residents get PM Surya Ghar subsidy under the new proposal?

Societies and RWAs can already get CFA for common facilities (₹18,000/kW, up to 500 kW at 3 kW per house, on a dedicated connection), and group or virtual net metering installations on a roof are eligible if the DISCOM approves the arrangement (guidelines, clauses 5(b), 5(e), 5(f)). Press reports say a redesign might extend support to apartment residents and households without a suitable rooftop through virtual net metering, group net metering, balcony solar, building-integrated photovoltaics, and community plants of around 100 kW. That is unconfirmed and not a currently available option.

Will the current PM Surya Ghar subsidy slabs change immediately?

No. The current subsidy structure, up to ₹78,000 for a 3 kW system, remains in effect, and the guidelines set the scheme period to 31 March 2027 (clause 2(d)). Any new framework would need an official paper, further consultation, and likely Cabinet approval before becoming operational, a process that typically takes months, not weeks. For current figures, see our guide to PM Surya Ghar subsidy slabs.

What happens to installers whose vendors have already exited the market?

Under the current guidelines, registered vendors must provide repair and maintenance free of cost for 5 years from commissioning (clause 7(d)), and a vendor can be de-registered after notice if systems are substandard (clause 7(e)). Press reports say MNRE officials flagged vendor exit as a Phase 1 gap and are considering stricter maintenance obligations, mandatory service periods and equipment-failure insurance. Those are unconfirmed proposals, not current requirements. Homeowners currently facing this issue should check their original vendor's registration status on the PM Surya Ghar national portal and consult their state DISCOM or nodal agency.

When will PM Surya Ghar 2.0 be officially launched?

Neither source report gives a confirmed launch date, and we found no official announcement as of 31 Oct 2026. The reports expected a policy paper within weeks of the July 24, 2026 consultation, which has not appeared in anything we could find. Formal notification and launch would follow further review and, in our view, is not likely before 2027.

Want to put this into practice?

Quickest Solar CRM gives you everything in this article, proposal automation, lead capture, WhatsApp follow-up, built for Indian solar EPCs.

Start free
